Construction Schedule Template

Updated on April 17, 2024
Article byWallstreetmojo Team
Edited byWallstreetmojo Team
Reviewed byDheeraj Vaidya, CFA, FRM

Overview of Construction Schedule Template

A construction schedule template gives a detailed overview of the tasks involved in the entire project and all the phases of work/construction needed to complete the project. It helps create a plan for a whole project regarding the timeline or schedule involved. In addition, it typically helps engineers to plan and complete the project on time and within budget.

Construction-Schedule-Template

You are free to use this image on your website, templates, etc, Please provide us with an attribution linkHow to Provide Attribution?Article Link to be Hyperlinked
For eg:
Source: Construction Schedule Template (wallstreetmojo.com)

About the Construction Schedule Template

A construction scheduling template gives a detailed breakdown of the hierarchical structure of a complete project based on the task/deliverables which need to be accomplished by the project team or the project engineer, where it gives a detailed explanation of the time and budget. It is one of the most critical deliverables for every project engineer because it helps organize the entire project into a time-based frame. The template also has a visual chart, making it easy for the project manager or the project engineer to track the progress of each activity.

Financial Modeling & Valuation Courses Bundle (25+ Hours Video Series)

–>> If you want to learn Financial Modeling & Valuation professionally , then do check this ​Financial Modeling & Valuation Course Bundle​ (25+ hours of video tutorials with step by step McDonald’s Financial Model). Unlock the art of financial modeling and valuation with a comprehensive course covering McDonald’s forecast methodologies, advanced valuation techniques, and financial statements.

How to Use the Template?

Part #1

Construction schedule template Part 1
  • This section is the basic details about the entire project or construction. It highlights the project name and the name of the project manager or project engineer undertaking the construction. The start and end date are the key dates when the project has begun from scratch, which involves the planning it, and the end date, which involves the final wrapping up of the construction and handover.
  • The total duration field helps us determine the number of days, months, or years the project will take to attain completion. The start date and duration of each activity are the critical criteria required for building the Gantt chart, which will be discussed later in this article.

Part #2

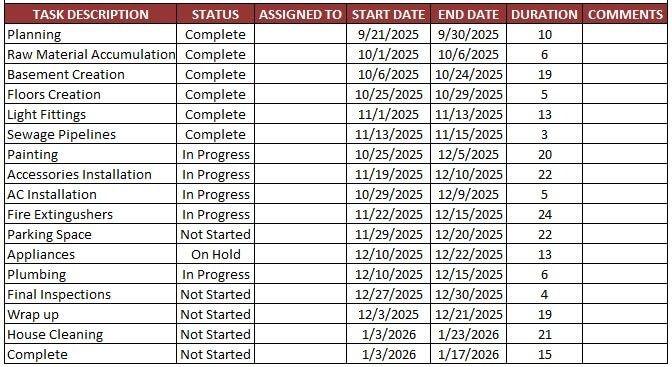

Construction schedule template Part 2
  • It is the most crucial section of a construction scheduling template. It is the area where the engineer or manager can check the numerous tasks involved with the construction, track the status of it, and have information about the task’s start and end date and duration.
  • There are four status options to track all the tasks, which areas are completed, in progress, on hold, and not started.
  • Every task involved is tagged against each status, and based on this, the project manager or the engineer will deploy resources. If any task overlaps with some other or is beyond the deadline, the manager or the engineer will deploy more resources toward it accordingly.
  • In this case, an example of simple construction was taken where the entire construction schedule was broken down into simpler activities and tagged along with a start and end date. Then, based on each task, a concerned person responsible is tagged against each.
  • This template captures all the phases of an entire construction schedule, from the planning phase to the final project handover. It provides both table-wise and chart-wise representations of data about the start and end date of each task involved with the construction. Based on the duration of each activity, the project engineer or manager has to plan out the project’s completion date or date of handover. It involves the final inspection of the building, final wrapping up, setting up the housekeeping activities, and announcing the completion.
  • Overlapped activities should be the key concern of every engineer as it may require sharing some resources for the same. Therefore, the manager or the engineer must plan it accordingly so that there is no shortfall of resources and each task gets completed on time.
  • Thus this template, in combination with a Gantt chart, becomes even more beneficial for the engineer or the manager. We will discuss a detailed overview of visual representation using the Gantt chart in the following part below.

Part #3

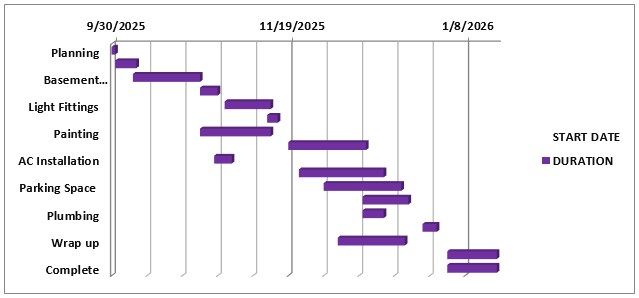

Part 3
  • This is a typical example of the Gantt chart where each construction task schedule is shown based on its start date and duration. The overlap with other tasks is visible to help the project engineer plan the task or deployment of resources accordingly.
  • The chart shows all the phases of an entire construction schedule captured in this template, starting from the phase of planning to the final project handover. Gantt chart helps the project manager or the project engineer plan all the activities related to the construction systematically.
  • Any overlap of activities should be the key concern for the engineer as it may require sharing some resources for the same. Therefore, the manager or the engineer has to plan it accordingly so that there is no shortfall of resources and each task gets completed on time.

Conclusion

  • A construction schedule template plays a significant role for any project engineer or manager when a major construction involves a lot of resources, time, and stages.
  • One cannot just start a project without proper planning. This template is a very good example of bringing about proper planning when it comes to starting construction. It provides both table-wise and chart-wise representations of data about the start and end date of each task involved with the construction. Then, based on the duration of each activity, the project engineer or manager has to plan out the project’s completion date or date of handover.
  • It involves the final inspection of the building, final wrapping up, setting up the housekeeping activities, and announcing the completion. This template comes into use not only in small project projects, which may involve the construction of a single building, but it can also help in large infrastructure projects like the construction of highways, townships, dams, power projects, flyovers, railways projects, etc. It solely depends on the project manager or the engineer how the entire construction vision is broken down into simpler tasks or activities and planned accordingly.

Recommended Articles

This article has been a guide to the construction schedule template. Here, we provide you with a free downloadable construction schedule template that gives a detailed overview of the tasks involved in the entire project or phases of work.

Also, you can download and use this template in Excel, PDF, or ODS format.

Reader Interactions

Comments

  1. Gidey tesfay says

    I want to know, and to shar.

  2. David Ochieng says

    A great resource. Thank you.

Leave a Reply

Your email address will not be published. Required fields are marked *
